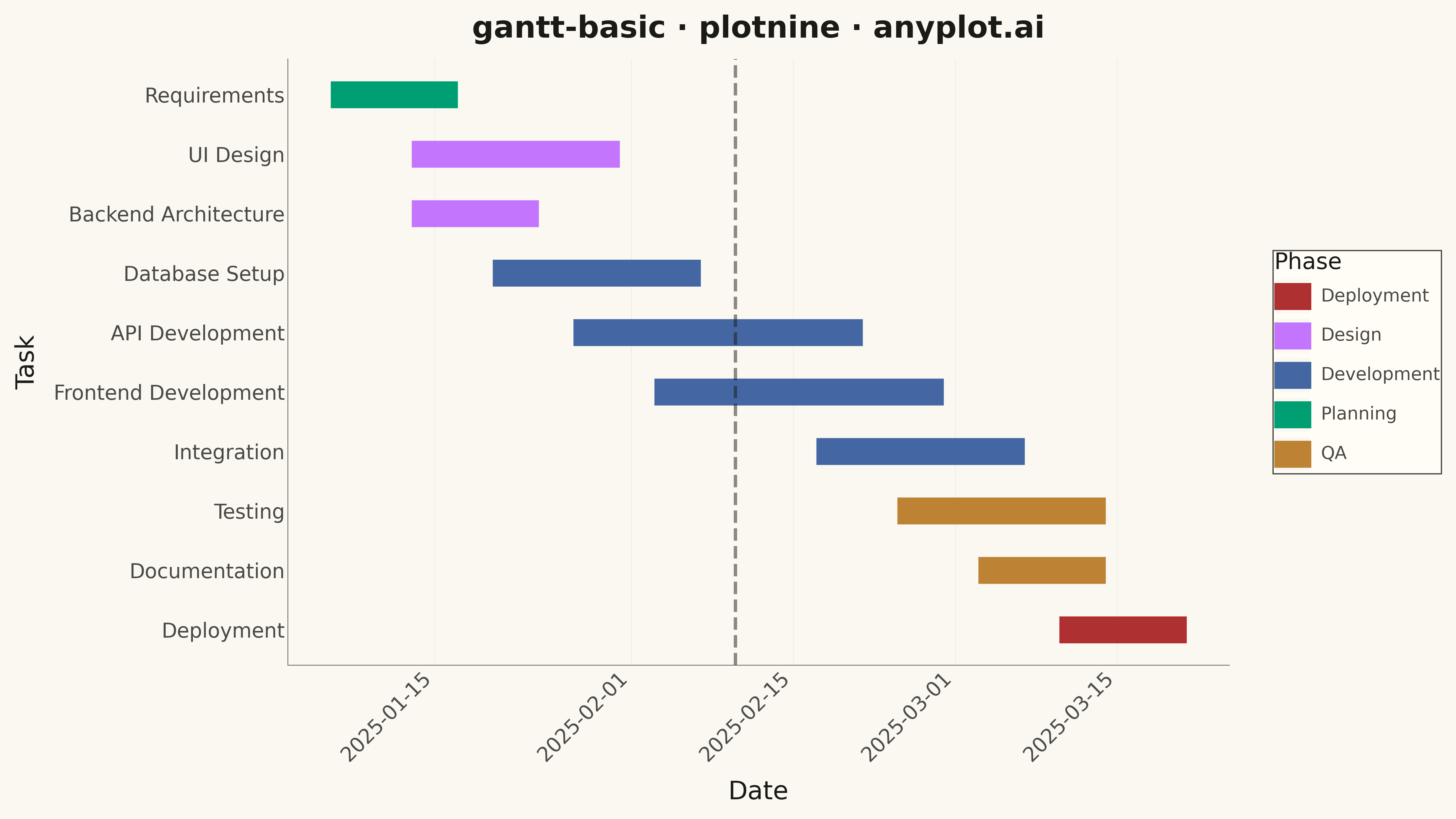

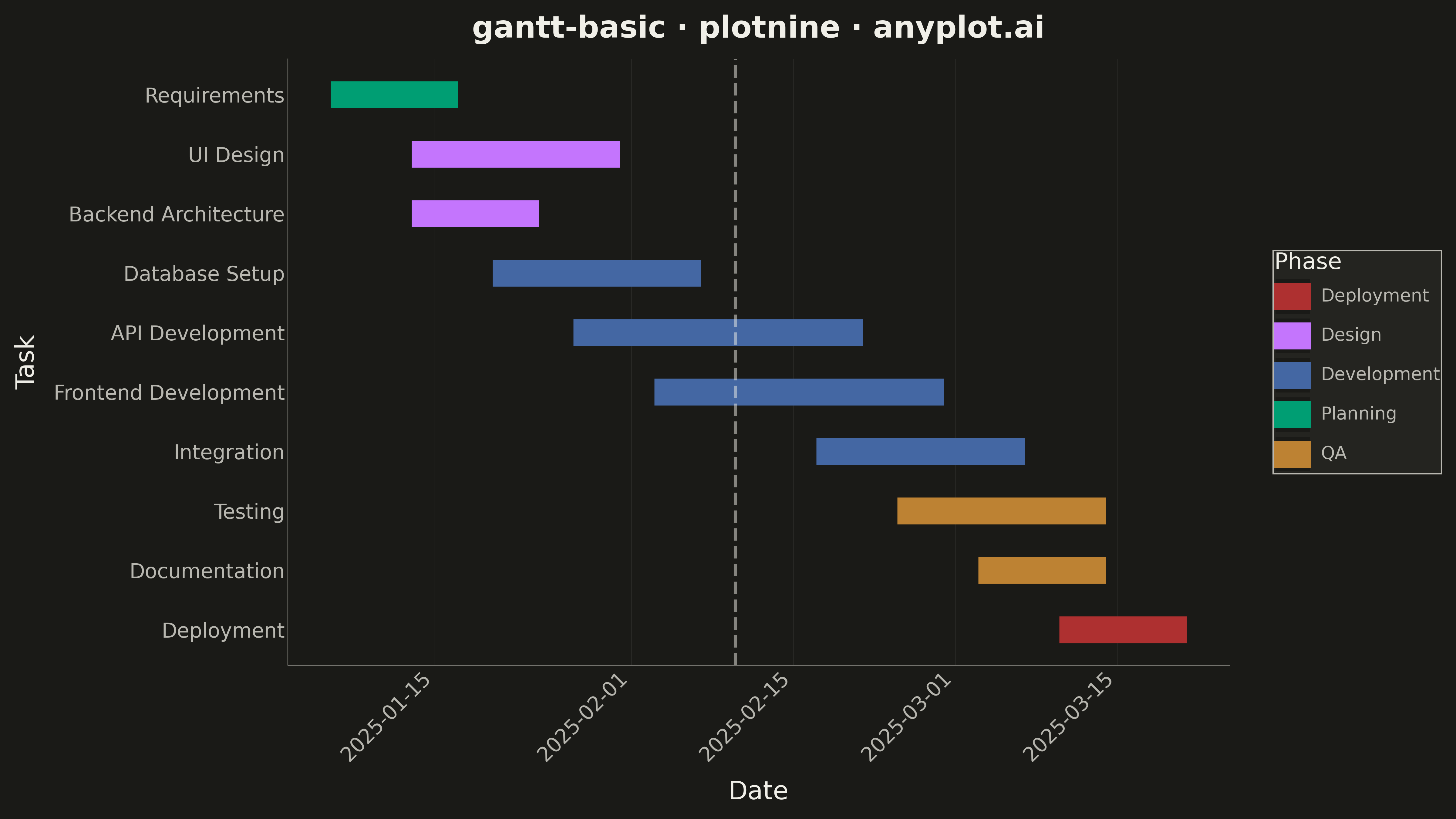

A Gantt chart is a horizontal bar chart that visualizes project schedules and timelines. Each task is represented as a horizontal bar spanning from its start date to end date, making it easy to see task durations, overlaps, and the overall project timeline at a glance. Gantt charts are essential for project management, helping teams understand task sequences and identify scheduling conflicts.

""" anyplot.ai
gantt-basic: Basic Gantt Chart
Library: plotnine 0.15.4 | Python 3.13.13
Quality: 90/100 | Updated: 2026-05-10
"""
import os
from datetime import datetime
import pandas as pd
from plotnine import (
aes,
element_blank,
element_line,
element_rect,
element_text,
geom_segment,
geom_vline,
ggplot,
labs,
scale_color_manual,
scale_y_discrete,
theme,
theme_minimal,
)
# Theme tokens
THEME = os.getenv("ANYPLOT_THEME", "light")
PAGE_BG = "#FAF8F1" if THEME == "light" else "#1A1A17"
ELEVATED_BG = "#FFFDF6" if THEME == "light" else "#242420"
INK = "#1A1A17" if THEME == "light" else "#F0EFE8"
INK_SOFT = "#4A4A44" if THEME == "light" else "#B8B7B0"
# Okabe-Ito palette (5 categories)
IMPRINT = ["#009E73", "#C475FD", "#4467A3", "#BD8233", "#AE3030"]
# Data - Software development project schedule
data = {
"task": [
"Requirements",
"UI Design",
"Backend Architecture",
"Database Setup",
"API Development",
"Frontend Development",
"Integration",
"Testing",
"Documentation",
"Deployment",
],
"start": [
datetime(2025, 1, 6),
datetime(2025, 1, 13),
datetime(2025, 1, 13),
datetime(2025, 1, 20),
datetime(2025, 1, 27),
datetime(2025, 2, 3),
datetime(2025, 2, 17),
datetime(2025, 2, 24),
datetime(2025, 3, 3),
datetime(2025, 3, 10),
],
"end": [
datetime(2025, 1, 17),
datetime(2025, 1, 31),
datetime(2025, 1, 24),
datetime(2025, 2, 7),
datetime(2025, 2, 21),
datetime(2025, 2, 28),
datetime(2025, 3, 7),
datetime(2025, 3, 14),
datetime(2025, 3, 14),
datetime(2025, 3, 21),
],
"category": [
"Planning",
"Design",
"Design",
"Development",
"Development",
"Development",
"Development",
"QA",
"QA",
"Deployment",
],
}
df = pd.DataFrame(data)
# Order tasks by start date (reversed for bottom-to-top display)
df = df.sort_values("start", ascending=True)
df["task"] = pd.Categorical(df["task"], categories=df["task"].tolist(), ordered=True)
# Map categories to Okabe-Ito colors
category_colors = {
"Planning": IMPRINT[0],
"Design": IMPRINT[1],
"Development": IMPRINT[2],
"QA": IMPRINT[3],
"Deployment": IMPRINT[4],
}
# Current date marker
today = datetime(2025, 2, 10)
# Create the Gantt chart
plot = (
ggplot(df, aes(x="start", xend="end", y="task", yend="task", color="category"))
+ geom_segment(size=12)
+ geom_vline(xintercept=today, linetype="dashed", color=INK, size=1.5, alpha=0.5)
+ scale_color_manual(values=category_colors)
+ scale_y_discrete(limits=df["task"].tolist()[::-1])
+ labs(title="gantt-basic · plotnine · anyplot.ai", x="Date", y="Task", color="Phase")
+ theme_minimal()
+ theme(
figure_size=(16, 9),
plot_background=element_rect(fill=PAGE_BG, color=PAGE_BG),
panel_background=element_rect(fill=PAGE_BG),
plot_title=element_text(size=24, face="bold", color=INK),
axis_title_x=element_text(size=20, color=INK),
axis_title_y=element_text(size=20, color=INK),
axis_text_x=element_text(size=16, rotation=45, ha="right", color=INK_SOFT),
axis_text_y=element_text(size=16, color=INK_SOFT),
axis_line=element_line(color=INK_SOFT, size=0.5),
legend_title=element_text(size=18, color=INK),
legend_text=element_text(size=14, color=INK_SOFT),
legend_background=element_rect(fill=ELEVATED_BG, color=INK_SOFT),
legend_position="right",
panel_grid_major_y=element_blank(),
panel_grid_minor=element_blank(),
panel_grid_major_x=element_line(color=INK, size=0.3, alpha=0.10),
)
)
# Save the plot
plot.save(f"plot-{THEME}.png", dpi=300, width=16, height=9)
